Romford Road Public Realm Improvement scheme
Romford Road is a key east-west route in Newham, connecting Stratford in the west to Little Ilford and the North Circular (A406) in the east. It provides important connections for pedestrians, cyclists and buses as well as private and commercial vehicles.
The key aim of the Romford Road Public Realm Improvement scheme is to create a better and safer street environment for residents, businesses, visitors and people travelling to destinations within the borough.

Visualisation of Romford Road, looking West at the junction of Upton Lane and Woodgrange Road.

Last updated 29 September 2026

Ongoing construction works in the sections mentioned below may affect traffic flows. This is due to temporary traffic lights, temporary bus stops, and parking / loading suspensions and access restrictions to side roads.
Junction 2 - Upton Lane / Woodgrange Road
Works to complete Junction 2 (Upton Lane / Woodgrange Road) will begin on 19 October 2026 and are expected to last until spring/summer 2027.
This substantial works package will include new segregated cycle lanes for safer cycle travel, a completely new junction layout with relocated crossing facilities to provide safer and easier crossing points, a new traffic light system to aid traffic flow, new soft landscaping to increase the biodiversity in the area, newly resurfaced carriageways for a smoother driving experience and large areas of ornamental paving on the footway to improve the overall look and feel of the area.
During this time there may be temporary traffic lights and other measures in place that may affect traffic flows during construction. We would like to confirm that full access will remain to all business premises at all times.
If you encounter any issues please do not hesitate to speak to a member of the team on site or contact our contractor, Marlborough Highways by phone on 020 7739 2976 or by e-mail on enquiries@marlboroughhighways.co.uk.

Phase 1 – Start date end of October 2026 - Expected completion end of November 2026
Phase 2 – Start date beginning of January 2026 - Expected completion mid-January 2027
Phase 3 – Start date mid-January 2026 - Expected completion end of January 2027
Phase 4 – Start date mid-February 2026 - Expected completion beginning of March 2027
Phase 5 – Start date beginning of March 2026 - Expected completion mid-March 2027
Phase 6 – Start date mid-March 2026 - Expected completion beginning of April 2027
Phase 7 – Start date mid-April 2026 - Expected completion end of April 2027
Phase 8 – Start date beginning of March 2026 - Expected completion mid-March 2027
Phase 9 – Start date end of January 2026 - Expected completion beginning of March 2027
Phase 10 – Start date start of November 2026 - Expected completion mid-December 2026
Phase 11 – Start date beginning of December 2026 - Expected completion mid-December 2026
Phase 12A – Start date end of March 2026 - Expected completion beginning of April 2027

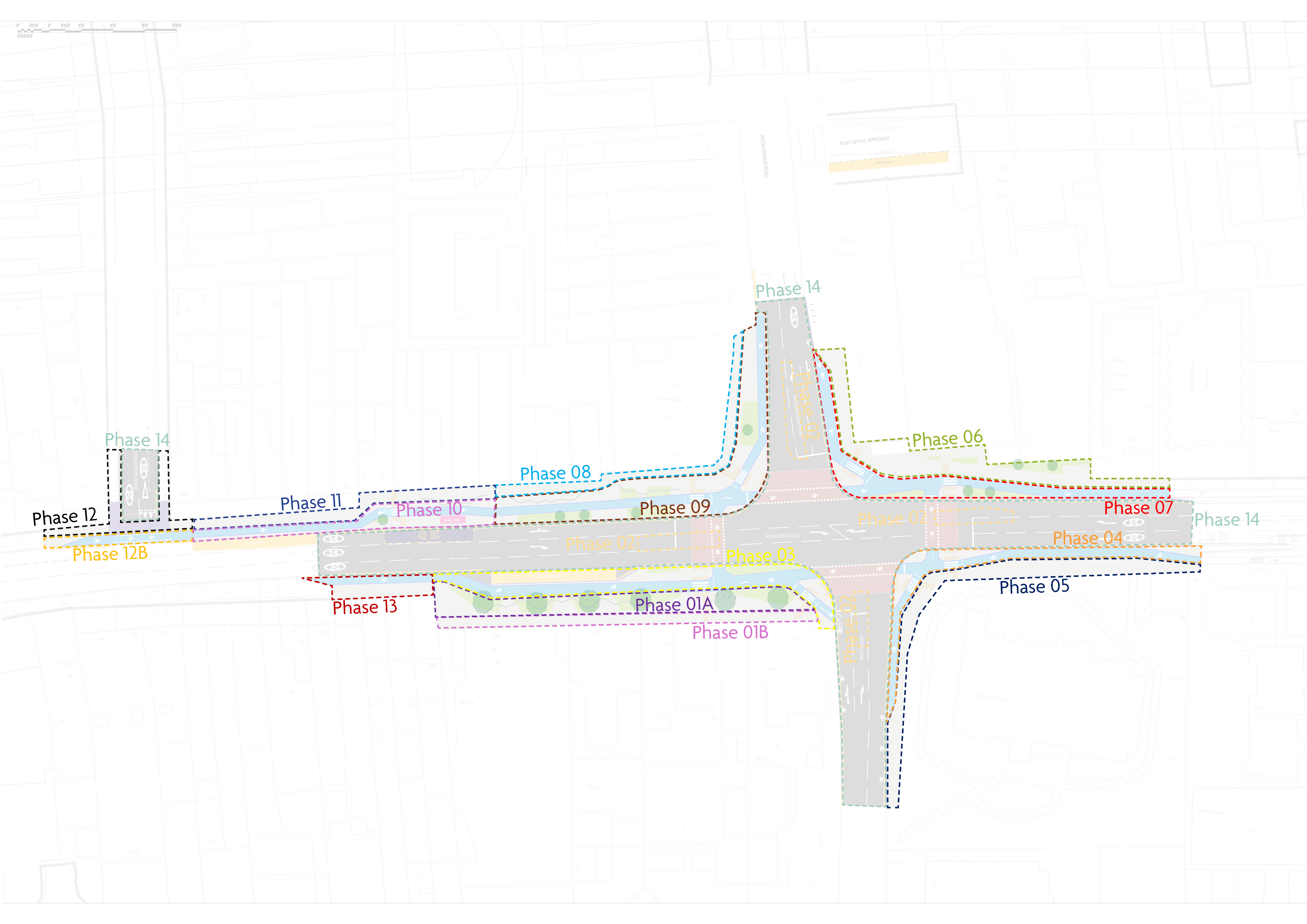

Phase 6 & Phase 12A TM Drawing
Phase 12B – Start date beginning of April 2026 - Expected completion mid-April 2027
Phase 6 & Phase 12B TM Drawing
Phase 13 – Start date end of November 2026 - Expected completion mid-December 2026
Phase 14 – Start date end of April 2026 - Expected completion end of April 2027
Junction 3 - Green Street / Richmond Road
Construction completed in July 2026 and was opened by the project team and Dr. Will Norman, London's Walking and Cycling Commissioner as shown in the video below.
Junction 7 - Little Ilford Lane / Colchester Avenue
Works to complete Junction 7 (Little Ilford Lane/ Colchester Avenue) began in June 2026 and are expected to last until January 2027. During this time there may be temporary traffic lights and other measures in place that may affect traffic flows during construction.

Click the PDF below to view a copy of the large banners that appear on the construction site.

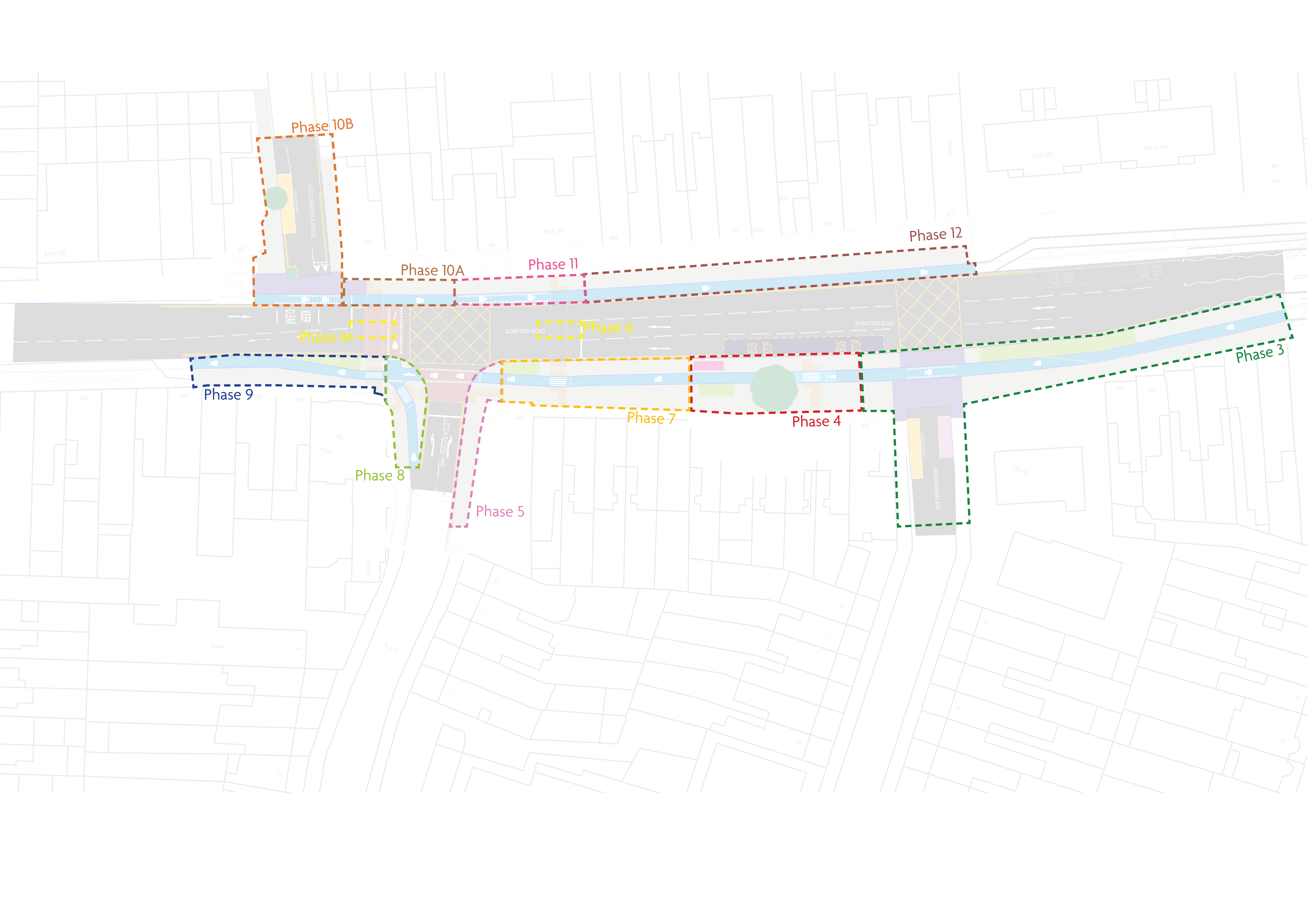

Phase 3 – Works completed
Phase 4 – Start date end of June 2026 - Expected completion end of August 2026
Phase 5 – Start date mid-August 2026 - Expected completion mid-September 2026
Phase 6 – Start date beginning of September 2026 - Expected completion mid-September 2026
Phase 7 – Start date mid-September 2026 - Expected completion beginning of November 2026
Phase 8 – Start date mid-October 2026 - Expected completion mid-November 2026
Phase 9 – Start date end of October 2026 - Expected completion beginning of December 2026
Phase 10A – Start date mid-November 2026 - Expected completion mid-December 2026
Phase 10B – Start date beginning of November 2026 - Expected completion beginning of January 2027
Phase 11 – Start date end of September 2026 - Expected completion beginning of January 2027
Phase 12 – Start date beginning of September 2026 - Expected completion mid January 2027
Please note that dates are indicative and may be subject to change as works progress.
Section F construction works
Construction works from no. 497 to no.577 Romford Road (northern footway), part of the section referred to as ‘Section F’, commenced in early February and are expected to be completed by October 2026. At some points during construction there may be temporary bus stop closures or bus stop relocations; and temporary parking and loading restrictions.
Note: To protect planting equipment against ongoing vehicle damage, we are installing boulders in some areas. If you notice any further damage, please report it to us at stromfordroad@newham.gov.uk
Contact us
Romford Road team | e: STRomfordRoad@newham.gov.uk

Visualisation of Romford Road, looking East at the junction with Richmond Road and Green Street

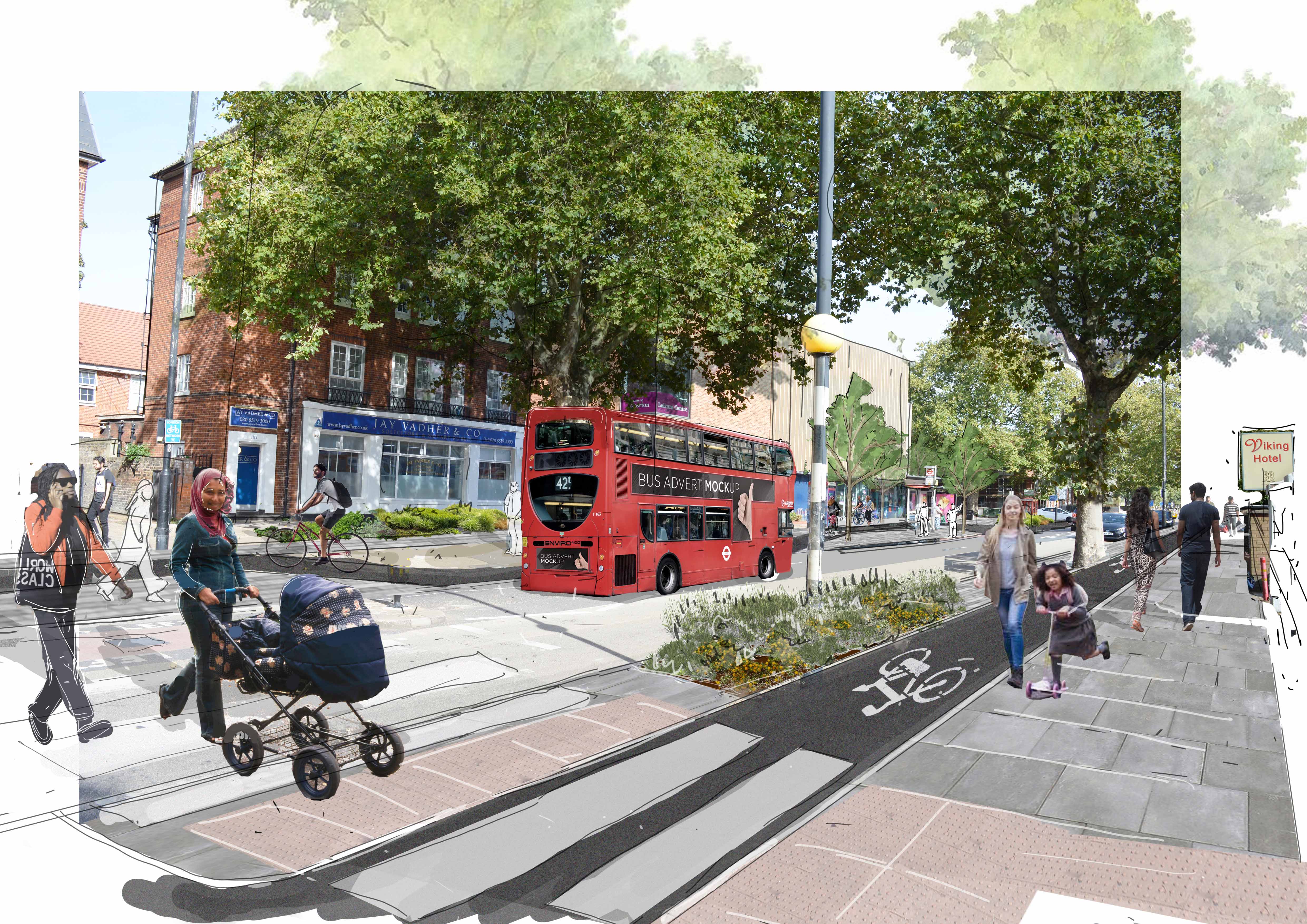

Visualisation of Romford Road, looking East towards Atherton Leisure Centre

Phases
Richmond Road early engagement
Share your views on design changes to Richmond Road.
Events
Past events

Event date: July 29th, 2026 from 12:30 PM to 4:30 PM.
Aston-Mansfield Community Centre (Formally Froud Centre)
2 registrants

Event date: July 9th, 2026 from 3:30 PM to 6:30 PM.
Forest Gate Library
9 registrants

Event date: December 13th, 2025 from 9:00 AM to 3:00 PM.
Atherton Leisure Centre

Event date: September 13th, 2025 from 9:00 AM to 3:00 PM.
Atherton Leisure Centre
Event date: August 20th, 2025 from 3:30 PM to 6:30 PM.
Forest Gate Library
3 registrants

Event date: April 17th, 2025 from 9:00 AM to 3:00 PM.

Event date: February 27th, 2025 from 4:00 PM to 7:30 PM.
1 registrant

Event date: January 28th, 2025 from 4:00 PM to 7:30 PM.
Manor Park Library
1 registrant

Event date: December 15th, 2024 from 12:00 PM to 3:30 PM.
685-693 Romford Rd

Event date: September 12th, 2024 from 1:00 PM to 4:00 PM.
1 registrant
